Warehouse Demolition Planning in Dubai: Steel Frames, Slabs & Free-Zone Logistics

Image link

Warehouse demolition in Dubai starts by defining what is removed, what stays and the condition in which the site must be handed back. The correct method depends on the building’s structural system, the stability of its roof and bracing, occupied neighbours, utility releases, access for equipment and trucks, and whether slabs and foundations are included. Confirm the plot’s permitting authority before setting the programme. Steel scrap value should be stated separately from the demolition scope.

For projects requiring complete industrial-structure removal, Stone Beam Demolition provides industrial demolition services. We dismantle steel structures, including sheds and mezzanines, under an engineer-approved method; our demolition planning covers structural review, method statements, risk assessments, workfront controls and debris removal. Send your drawings for a scope and quotation review once the intended handover boundary is clear.

By Eng. Awad Ashour, Founder & CEO, Stone Beam Demolition

Eng. Awad Ashour has more than 15 years of demolition experience in the UAE.

What does warehouse demolition actually include?

A warehouse demolition quotation should describe five different boundaries. An instruction to “demolish the warehouse” does not, on its own, establish whether the ground slab, foundations, machinery or stored contents are included. The buyer should approve one marked-up scope drawing and one handover condition before requesting comparable bids.

  • Above-ground structure: cladding, purlins, bracing, rafters or trusses, columns, doors and internal steelwork.
  • Internal interfaces: mezzanines, offices, MEP, HVAC equipment, racking, cranes, services and retained assets.
  • Ground-level and below-ground work: slab, equipment bases, pits, foundations, hardstanding and buried services.
  • Commercial interfaces: salvage ownership, debris handling, transport, disposal evidence and measurement basis.
  • Handover: slab retained or removed, foundations retained or removed, any independently scoped reinstatement, grading and final acceptance evidence.

For a steel-only assignment, the relevant scope is steel dismantling. Where the building contains an operating production line, process plant or stored hazardous materials, the demolition boundary must also be separated from the operator’s decommissioning obligations.

How does the warehouse structural system change the method?

Before selecting a method, compare the as-built record with the actual building: structural frame, connection types, roof system, bracing, secondary steel, intermediate floors, alterations and condition. These observations decide which method families deserve further engineering review; they do not themselves authorise any connection release or structural removal.

Steel portal and pre-engineered frames

In a portal-frame or pre-engineered steel warehouse, the rafters, columns, purlins and bracing form an interconnected system. A recoverable steel package requires inspection of connections and member condition, identification of material to preserve, and engineering of the temporary stable conditions and lifting interfaces. A corroded frame or one with undocumented alterations may call for a different approach from an intact, fully documented shed.

Precast, reinforced-concrete and masonry warehouses

Precast panels, cast-in-situ frames, beams and slabs introduce different support, connection and debris-handling considerations. Masonry might be infill, an independent partition or part of a boundary that must remain. The engineer needs to establish which elements are structural and which adjoining components depend on them before defining demolition limits.

Mezzanines and live-service interfaces

A mezzanine, gantry crane, overhead service, tenant office or live fire-protection system can turn a simple shell removal into a retained-asset problem. The survey should identify its load path, supports, service connections, owner and required condition after the works. Include these interfaces as named scope items rather than hiding them under “miscellaneous steel”.

When should steel be dismantled, cut or mechanically demolished?

Dismantling is aimed at controlled recovery; cutting divides structures into manageable sections under an engineered plan; mechanical removal is suitable for selected non-recoverable workfronts where access, ground and exclusion arrangements allow it. A warehouse may require more than one approach.

Route Planning objective Key inputs before release Main interface Commercial effect
Dismantle for recovery Preserve identifiable steel or components Connection survey; condition; piece handling; lifting access Remaining-frame stability and controlled landing More handling and segregation; recovery value stays a separate commercial line
Controlled cutting Create manageable pieces where connections cannot simply be released Engineer-determined cut locations; piece weights; support and lifting plans; hot-work status Suspended load, retained structure and fire control More secondary cutting and handling; recovery quality depends on the cut plan
Mechanical removal Remove non-recoverable structure in bulk under an approved demolition strategy Plant access; ground condition; reach; exclusion zone; adjacency Debris trajectory, retained assets and site logistics Bulk-processing emphasis in suitable workfronts; more mixed debris handling

Buyer decision: ask each tenderer to explain why its proposed method suits your actual frame, what engineering and lifting submissions it requires, and whether recoverable material is part of the price or a separately valued item. For a pre-engineered building (PEB), compare a recovery-led proposal with a non-recovery proposal only after both bidders state the same slab/foundation boundary and handover condition. Record separately the steel quantity or measurement basis, proposed condition on delivery, ownership, handling and transport, and whether the scrap value is a credit, an allowance or excluded. A forecast salvage value is not an assured discount. The approved demolition plan and method statement carries the project-specific details.

How are the roof, bracing and steel frame kept stable?

A steel warehouse is not a collection of independent beams. Roof sheeting, purlins, rafters, columns and bracing can all influence structural stability. The designer must assess which load paths and restraints are needed at each approved workfront, including conditions revealed by previous modifications or deterioration. The contractor’s proposal must not assume that removing cladding or a non-primary member is automatically harmless.

A sound planning review checks the following:

  • The actual frame, bracing, fixings and connections against drawings and physical observations.
  • The role of roof sheets and secondary members in restraining the primary structure.
  • Requirements for retained bays, party walls, shared services and adjoining occupied areas.
  • Equipment access, lifting interfaces, ground condition and safe material landing or laydown space.
  • Responsibility for temporary-works design, lifting design, structural release and consultant acceptance.

Stone Beam dismantles steel sheds, mezzanines and canopies in an engineer-approved sequence. Our method statement and risk assessment are submitted to the consultant before work starts. BS 6187:2011, the UK Code of practice for full and partial demolition, is useful technical guidance for planning, but it does not substitute for Dubai’s project approvals. See the BSI publication.

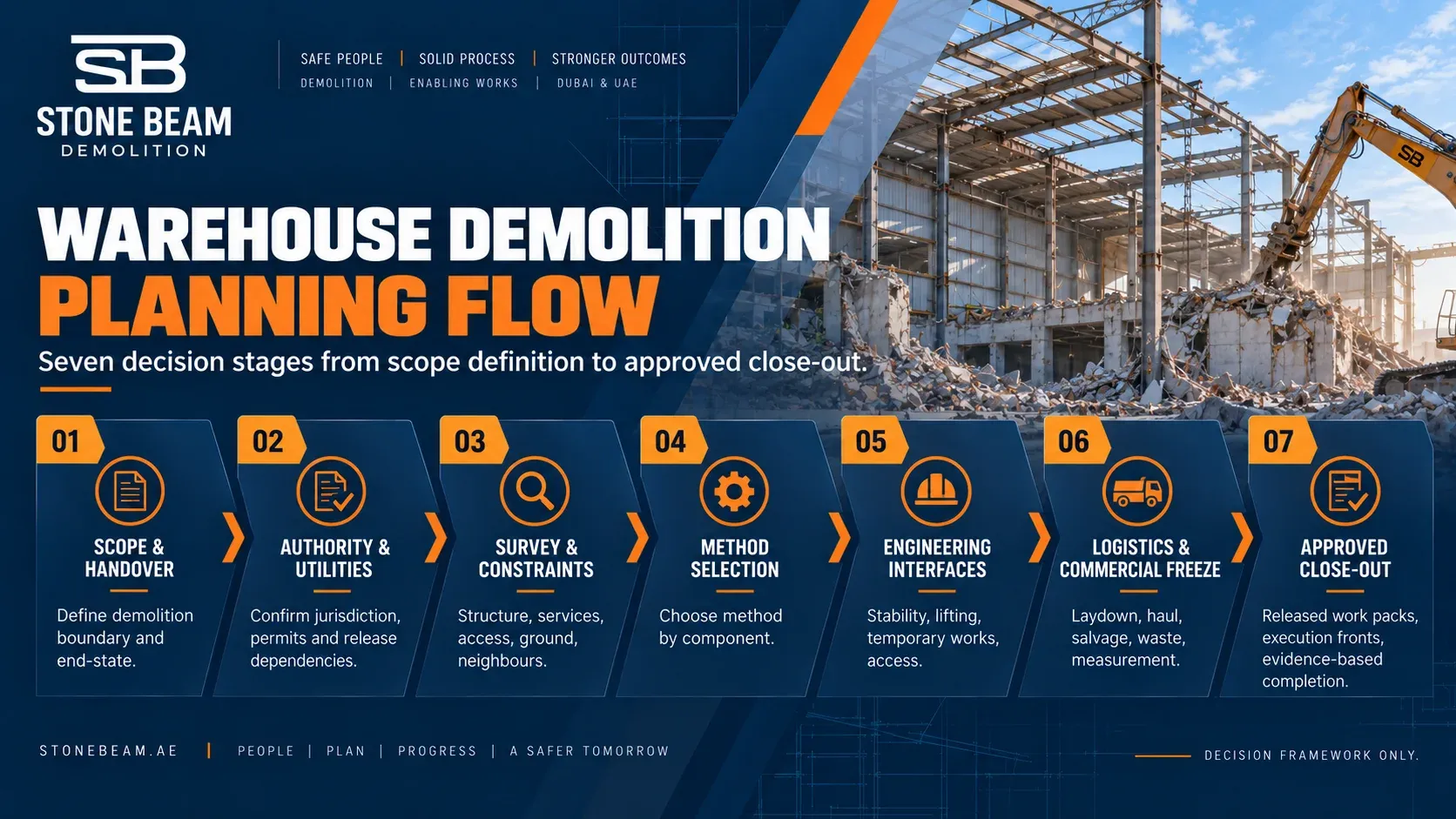

Conceptual planning flow: defined handover boundary → structural and service information → authority and owner interfaces → engineer-reviewed method family → approved workfront controls → measured removal and waste records → agreed handover evidence. The structural engineer and approved method statement govern the actual physical sequence.

Conceptual warehouse demolition planning decision flow from scope definition to final handover

Are the slab, foundations and buried structures included?

Only when expressly included in the scope. An above-ground steel demolition price should not be assumed to include a heavy ground-bearing slab, isolated footings, piles, pits, machine bases or contaminated fill. The engineer and client should identify these items separately, together with required formation levels and future use.

  • Slab retained: describe protection requirements, permissible damage, treatment of anchors and openings, and the final inspected condition.
  • Slab removed: identify the removal area, thickness information, buried services, concrete disposal and agreed formation level.
  • Foundations retained: list the pads, strip foundations, piles or bases remaining and treatment of exposed interfaces.
  • Foundations removed: state the surveyed boundary, adjacent assets, ground-risk information and required reinstatement condition.
  • Backfilling or compaction: place specifications, test records and acceptance responsibilities in a separately defined work item if the project requires them.

The contract should distinguish demolition completion from ready for the next construction package. Those are different acceptance standards.

What conditions change the method, logistics and recovery plan?

The restrictions that matter are often outside the building footprint. A warehouse with a narrow yard and a live adjacent business may require more management interfaces than an isolated building with generous laydown space.

  • Structural condition: corrosion, fire damage, altered connections, missing bracing or uncertain drawings.
  • Recovery objective: intact reuse, graded scrap and disposal require different identification and handling decisions.
  • Live equipment and services: equipment, electrical feeds, chilled systems, gas, fire protection and process lines need release records from the responsible parties.
  • Plant access: gate width and height, turning room, pavement and ground condition, overhead restrictions and buried services.
  • Landing and laydown: space to receive, sort, protect, stack and load material without obstructing retained operations.
  • Occupancy: neighbouring tenants, active yards, roads, shared loading docks and approved working windows.
  • Handover: whether the warehouse, slab, foundations and site surfacing are all included in the final condition.

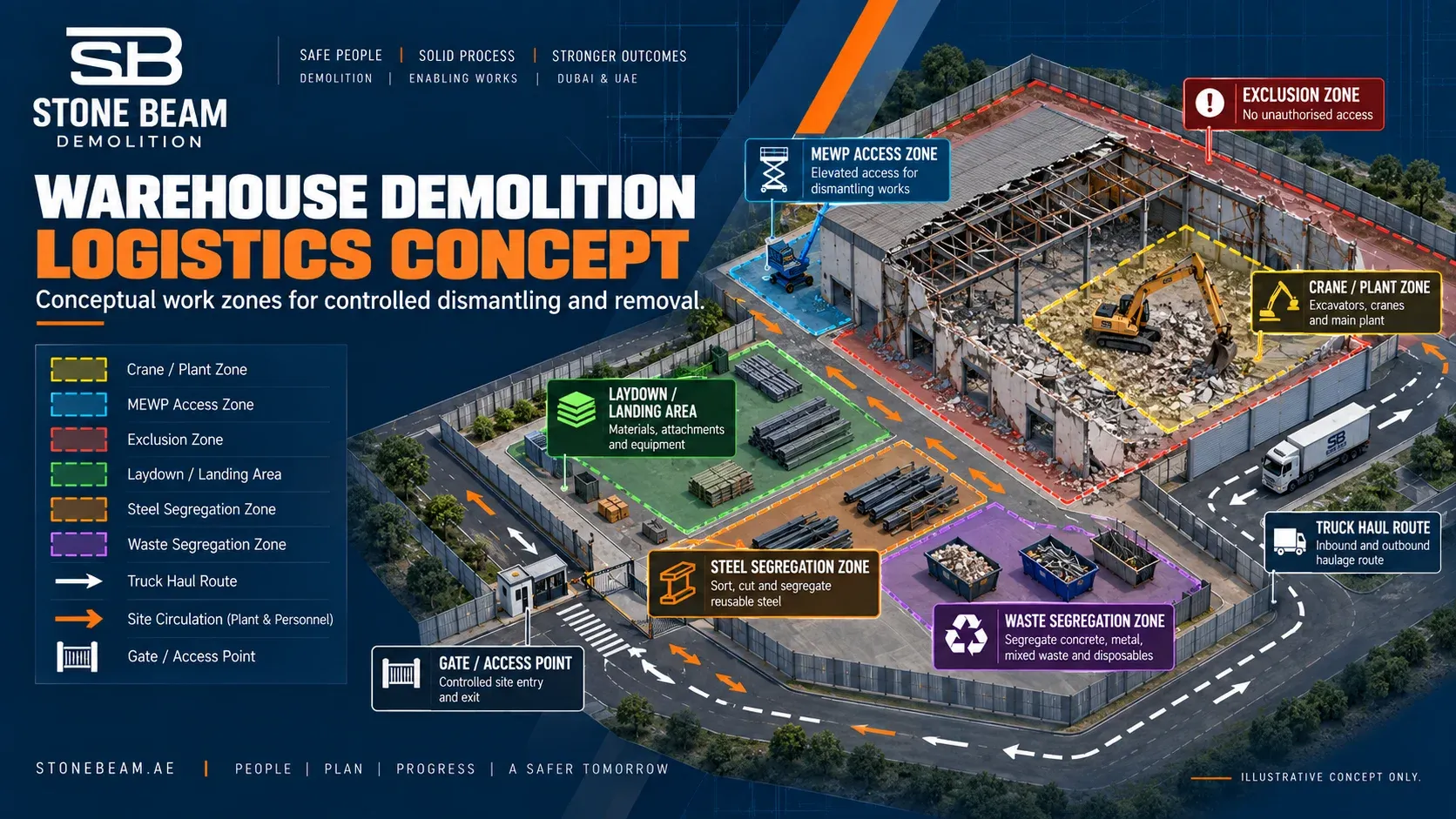

A logistics plan should distinguish work areas, protected assets, vehicle movement, segregated material areas and emergency access. It is a site-specific document, not a standard diagram copied between projects.

What if the warehouse shares a wall, bay or services with another unit?

Partial demolition is first a retention-design decision. The retained unit may depend on the removed building for bracing, lateral restraint, weather protection, fire separation, services, access or drainage. The owner and structural engineer should confirm the separating boundary and how the remaining premises will function after removal.

Interface at the boundary Question to resolve Evidence the buyer should request
Shared or linked structural frame Can the retained bay stand independently under the approved permanent and temporary conditions? Structural survey and engineer’s approved retained-asset design
Roof and external envelope What weatherproofing and drainage remain after the adjacent part is removed? Defined making-good and acceptance specification
Party or fire-separating wall Which wall must remain and what standards apply to the completed separation? Owner/consultant boundary drawings and applicable approvals
Shared MEP and fire services Which assets remain live, are diverted, or require specialist isolation? Services ownership list and documented release/diversion responsibility
Tenant and goods access How will neighbouring operations and escape routes be protected? Approved access and business-interface plan

Conceptual partial warehouse demolition boundary showing remove interface and retained occupied warehouse areas

Illustrative boundary sketch (concept, not a design): REMOVE — proposed demolition bay | INTERFACE — shared frame, wall, services and weather line | RETAIN — occupied warehouse bay. Engineering release of the interface is a decision gate before the demolition method can be finalised.

Illustrative planning example — not a Stone Beam project: A landlord proposes removing one leased bay while a neighbouring tenant remains open. The first quotation excludes a new weather barrier and shared fire-service alterations; a second includes both. Before comparing prices, the landlord should obtain an engineer-approved retained-boundary scope and name who will provide the weatherproofing, services diversion and acceptance records. The price difference is then a defined contract choice rather than an unexplained contractor rate.

What changes for fire-damaged or potentially contaminated warehouses?

Warehouse use history matters because the building can contain materials or systems not obvious in a visual walk-through. A targeted survey and owner records should identify suspected asbestos-containing roofing or insulation, chemical residues, fuel tanks, refrigerants, batteries, contaminated pits and potentially affected ground. Assessment and any required removal or clearance of hazardous materials belong with appropriately authorised specialists; the demolition package can then be planned around their documented releases.

For a fire-damaged warehouse, evidence of heat exposure or distortion changes the information needed before entry, structural assessment and any recovery decision. Preserve investigation, insurer or authority holds until the responsible parties formally release the relevant areas. Do not treat a fire-damaged steel member as reusable simply because it appears straight.

For a warehouse with active production equipment, the operator’s specialists must release process, electrical and other hazardous systems before structural removal. Stone Beam undertakes the demolition-side dismantling of plant and facility structures after the operator’s specialists have isolated and cleared them; operational shutdown and gas-free certification remain specialist responsibilities.

What should be checked before pricing a cold-store warehouse?

A cold store is not simply a steel shed with thicker cladding. The owner should identify the refrigeration plant, refrigerant inventory and records, insulated panel types, controlled-temperature rooms, connected pipework and any shared services. Where hazardous residues, refrigerants or other regulated materials require specialist work, specify the responsible authorised specialist and the evidence of clearance as an input to the demolition quotation, rather than treating it as standard steel dismantling.

Cold-store interface What the buyer should establish Contract or programme decision
Refrigeration plant and refrigerant circuits Equipment ownership, existing system and operator records, status of specialist decommissioning Specialist release and equipment-retention boundary before structural demolition
Insulated wall and roof panels Panel construction and condition, attached services, possible hazardous constituents Separate material identification, waste route and any recovery requirement
Cold rooms, mezzanines and racking What remains, connected supports and retained adjacent operations Engineer-reviewed structural and tenant-interface scope
Shared power, alarms or fire systems Which neighbouring areas depend on each supply and who controls them Owner/utility/specialist releases and continuity of retained services
Tenant exit and final condition Lease reinstatement obligations, landlord inspection and removal limits Written acceptance criteria and who funds reinstatement outside the demolition package

This table assigns scope and evidence decisions. Authorised specialists set the relevant refrigerant, electrical and hazardous-material work procedures under their approved work packs.

Who issues demolition approvals in a Dubai warehouse project?

The correct route starts with the plot and competent authority, not just the word “Dubai” or the warehouse’s postal district. A building-authority approval, utility NOC, developer permission and contractor practice permit answer different questions.

Dubai warehouse demolition approval route covering Dubai Municipality DDA Trakhees and utility interfaces

Plot / interface Authority route to establish What to check before programming
Plot within Dubai Municipality’s building jurisdiction Dubai Municipality demolition permit service Full or partial scope, appointed parties, demolition submission and project conditions
Plot within Dubai Development Authority jurisdiction DDA Demolition Permit Contractor application, demolition-area plan, method statement, HSE/emergency and risk documents, neighbouring impact and applicable NOCs
Plot within PCFC/Trakhees jurisdiction Trakhees Demolition and Removal NOC Site plan, contractor/consultant documents, required NOCs, method statement, demolition drawings and the undertaking concerning effects on retained stability listed in its application form
Electricity and water networks DEWA Demolishing Permits – Electricity/Water Correct integrated application route, owner details, affected supplies and separate final-bill/clearance steps
Developer, road, telecom and occupied-site interfaces Relevant asset owner and authority Access, traffic/road restrictions, telecom disconnection, community or master-developer permissions

Plot-first check: A postal address alone cannot assign the demolition authority. For a warehouse described as being in Al Quoz, Ras Al Khor, Al Qusais, Dubai Investments Park, Dubai Industrial City, JAFZA, National Industries Park, Dubai South or Umm Ramool, obtain the plot’s site/affection plan and confirm the actual building-permit authority and developer conditions.

Official service facts, checked 6 November 2026: DDA lists an estimated five working days for its own demolition permit service and a published fee of AED 1,000 per unit per floor, plus AED 10 Knowledge Dirham and AED 10 Innovation Dirham per transaction. These DDA charges are authority fees, not a contractor’s warehouse-demolition price, and they must not be extrapolated across other authorities or assumed to define the number of chargeable units for your plot.

For Trakhees projects, use the current site-specific service schedule rather than borrowing DDA’s fees or processing estimate. Trakhees’ application form identifies required classes of documentation, including relevant NOCs and a method statement.

DEWA’s published demolition electricity/water service is free of charge and quotes 10 working days for combined demolition approval under that service. For projects using the Dubai Municipality Building Permit System, DEWA describes an integrated application route; other authority scenarios use DEWA’s channels. For its electricity application, DEWA lists an affection plan where the project is in a Dubai free-zone area; it also lists a setting-out plan showing the demolition area for partial demolition. Its water application separately lists a setting-out plan for partial demolition. Owner account settlement and clearance are separate from the contractor’s structural work; neither the 10-day service target nor a permit’s validity is a project-duration promise. DEWA service detail, checked 6 November 2026.

The wider Dubai demolition permit guide explains the project-permit and NOC distinction in more detail.

How should recovered steel, scrap and demolition waste be handled?

The tender must state whether roof sheets, structural steel, equipment, cables, doors and other materials are to be reused, sold as scrap, segregated for an authorised facility or disposed of. Material ownership is a contract term; nothing about using a dismantling method automatically transfers title to the contractor.

Ask for a separate scrap and waste schedule that records: the owner’s retained items; the party who owns removed materials; any agreed scrap-credit mechanism; who measures or weighs the material; who arranges transport; destination and acceptance evidence; and treatment of non-recoverable or hazardous material.

Dubai Municipality’s Circular No. 12-10-1 of 2023 addresses segregation and sorting of construction and demolition waste at demolition sites before transport, with records of quantities. The authority also publishes Technical Guideline No. 2 — Waste Collection and Transport. Apply current technical and facility requirements to the actual transport route and waste category, using an appropriately authorised waste carrier whose permit covers that task.

Stone Beam separates debris at the workfront and coordinates an appropriately authorised waste carrier to take loads to the applicable facility. Before transporting material, agree which authorised carrier and receiving facility will issue the relevant load tickets, acceptance receipts or weighbridge records, who will retain them and what the owner will receive at handover. See our construction and demolition waste disposal guide for the separate disposal decision.

How much does warehouse demolition in Dubai cost?

There is no responsible single AED-per-m² figure for all warehouse demolition. Gross warehouse floor area is useful for describing the property, but it does not establish steel tonnage, structural condition, access difficulty, slab thickness, buried-foundation quantities, hazardous-material requirements or the intended handover condition. A price without those boundaries is not yet a comparable quotation.

Warehouse demolition cost and bid comparison showing scope structure access slab utilities waste and handover factors

Cost driver Why it affects the quotation What to include in the RFQ
Building system and condition Steel recovery, precast handling and damaged concrete impose different engineering and plant requirements Frame type, heights, bays, structural drawings and condition record
Roof, cladding and internal fittings Fragile materials, fixings, insulation and MEP require separate scope and controls Roof/cladding specification; offices, equipment and racking inventory
Retained structure and neighbours Shared bracing, occupied premises and protections restrict the workfront Retained-asset plan, boundary survey and occupancy conditions
Access and logistics Equipment choice, lifting, haulage, laydown and approved working windows affect resources Gate and turning dimensions, ground information and loading route
Slab, bases, pits and foundations Below-ground concrete and reinstatement are separate measured risks Areas, thicknesses, drawings, survey data and removal depths
Service release and hazardous material Third-party surveys, clearances and pauses affect the programme, particularly for cold stores and process facilities Utility owner, refrigeration/process records, available release evidence and hazard reports
Waste and scrap Segregation, handling, carrier requirements and ownership alter the net commercial position Material title, scrap-credit basis, haulage and disposal responsibility
Handover and close-out Formation, reinstatement, testing and records are different deliverables Final levels, acceptance tests, survey and evidence schedule

To compare bids, ask tenderers to price the same written scope and label exclusions and provisional items separately. Request a distinct line for slab/foundation demolition, waste movement and disposal, authority charges, owner-provided releases, and any scrap credit. An apparent lower lump sum may simply move a substantial obligation back to the owner.

What should a bid-levelling sheet check?

Bid line Consistent comparison basis Risk if left unclear
Scope and quantity Separate steel/roof items, slab area in m², concrete volume in m³ where measured, and steel in tonnes where supported A small scope priced as full demolition
Salvage and ownership Owner-retained materials; steel/scrap ownership, measured quantity, credit or removal allowance and handover condition clearly defined A bid assumes valuable scrap belongs to the bidder or promises an unmeasured credit
Waste and haulage Handling and loading; transport unit or load allowance; receiving-facility and ticket responsibility Cart-away or disposal appears later as an extra
Permits, specialist releases and utilities Name each applicant, payer, account holder and party providing clearance evidence Waiting and authority costs fall between packages
Programme and access Agreed work windows, neighbouring occupation, survey/approval dependencies Unpriced restrictions or incompatible schedules
Handover, tax and changes Final level/condition, testing where specified, VAT presentation, provisional sums and variation basis Quotations cannot be compared net-for-net

Use this sheet alongside the component matrix below. Contractor rates remain project-specific; published authority application fees are a different cost category.

How can a QS normalise warehouse demolition bids measured in different units?

A cheaper headline does not establish a cheaper equivalent scope. Before ranking offers, prepare one comparison basis for each measured item, then seek clarification where a bidder has priced an area, tonnage or lump sum against a different removal boundary. The table below is a tender-review tool, not a rate schedule or an instruction to measure work without a survey.

Item to align Example of non-comparable tender bases Common evidence required Decision before award
Steel shell Gross floor area versus frame tonnage versus lump-sum shell removal Marked structural drawings; roof and cladding scope; included handling Decide whether the measurement includes roof, primary steel, bracing and loading
Industrial floor slab Floor area versus measured concrete volume Slab drawings or surveyed thicknesses; reinforcement and pits; removal limits State whether saw cutting, breaking, haulage and target level are included
Foundations and equipment bases Allowance versus measured concrete work Foundation register, verified depths where available and exclusion notes Convert unknown depths into an investigation or provisional-item rule, not a hidden fixed quantity
Recovered steel Gross scrap deduction versus separately measured net credit Written title to material, agreed weight/measurement basis and acceptance terms Show recovery handling costs and any credit as distinct commercial lines
Waste transfer Number of vehicle trips versus mass or lump-sum cart-away Material streams, authorised carriers, destination and record requirements Agree who provides transport documents and who absorbs changes in classified waste

Illustrative tender test: if one offer includes the frame but excludes the ground slab while another includes both, comparing their totals is misleading even when the same floor area appears on both quotations. Request a revised scope-aligned schedule before treating the difference as a saving.

Send your warehouse drawings for a scope and quotation review. Include the desired handover condition so the initial discussion can distinguish demolition, retained assets and potential variations.

How long does warehouse demolition take in Dubai?

The duration depends on two separate clocks: pre-construction release (surveys, decisions, permits, NOCs and workfront access) and site operations (approved structural removal, slab/foundation work, cart-away and handover). Published service times from authorities cannot be added together or treated as a construction programme without knowing which approvals are parallel, sequential or dependent on missing information.

Programme stage Release or deliverable Common reason for delay
Scope and information review Owner-approved removal/retention boundary, accessible drawings, occupancy data Undocumented additions, uncertain slab/foundation extent
Structural, condition and hazard review Verified frame information; competent specialist assessment where indicated Hidden connections, fire damage, inaccessible areas or suspected hazardous material
Authority and utility pathway Correct plot route, application documents, relevant NOCs and owner clearances Wrong authority assumption, unresolved accounts or incomplete submissions
Method and workfront approval Consultant-accepted method statement, structural/temporary-works and lifting interfaces Adjacent occupancy, unresolved stability or access design
Contents, equipment and non-structural removal Owner releases retained assets; cleared process or tenancy interfaces Remaining stock, undisclosed machinery or active services
Roof and cladding package Released material and access interfaces according to the approved method Fragile roofs, high-bay access, shared weatherproofing
Structural frame package Engineer-released method and handling strategy Irregular frame/bracing, lifting access and recovery requirements
Slab/foundation and reinstatement scope Defined below-ground removal and separately specified making good Buried services, uncertain concrete quantities or changing formation levels
Waste records, inspection and handover Facility acceptance records and agreed final-site condition Restricted load-out, missing tickets or unresolved retained items

A credible contractor programme should name the owner of each release, the decision required, the target milestone and the effect of change. Ask for a project-specific schedule after survey; the engineer-approved work method determines the physical order of roof, cladding and steel work.

What handover condition should be written into the contract?

The handover line is often the biggest difference between two apparently similar prices. Select the outcome you need before asking a contractor to offer a lump sum.

Handover condition Scope boundary Acceptance evidence to define
Superstructure removed; slab retained Frame, roof, cladding and agreed internal items removed; slab stays Retained-slab condition, cleanliness, openings/anchors treatment, agreed inspection
Superstructure + slab removed Warehouse and slab removed to agreed limits Formation level, buried-service status, debris clearance, edge/interface condition
Full above/below-ground removal Structure, slab, foundations and defined pits/bases removed Excavation limits, retained services/structures, final level and close-out records
Cleared and reinstated plot Defined demolition plus separately specified backfill/compaction or grading Material/specification basis, test/acceptance records, final survey or handover criteria

If your next contractor needs a tested formation or a clean slab suitable for continued use, specify that requirement as an acceptance criterion. “Site cleared” is not enough to convey it. For a leased warehouse, obtain the landlord’s reinstatement and surrender requirements before tender: a lease exit may demand removal of tenant installations while retaining the landlord’s slab, fire separation or services. That requirement is different from clearing a plot for redevelopment, and it determines who signs the final acceptance.

Which 11 items should the owner send with the RFQ?

A useful warehouse demolition RFQ starts with the site information that could change the method, responsibility, cost or programme. Send what is available and identify missing records openly.

  1. Plot location, affection/site plan and governing authority or free-zone/master-developer jurisdiction.
  2. Latest structural, architectural and MEP drawings, with alterations and available as-built information.
  3. A marked-up remove / retain / protect list, including adjoining bays and shared structures.
  4. Warehouse use history, current contents, stored products, cold-store/refrigeration or specialist process systems, and available hazard or contamination survey information.
  5. Utility status: live, isolated, disconnected, diverted or still awaiting owner/utility release.
  6. Site access: gates, height restrictions, permitted hours, proposed equipment access, traffic routes and laydown space.
  7. Slab, pit, foundation, hardstanding and buried-service scope, including drawings and required levels.
  8. Steel-recovery objective and legal/commercial ownership of recovered materials.
  9. Waste segregation, loading, transport, facility acceptance and record responsibilities.
  10. Final handover condition, acceptance party and intended follow-on works.
  11. Programme milestones, tenancy/operational restrictions and consultant/owner representatives.

Start with these documents and photos through the Stone Beam contact page. Where specialist reports are incomplete, the initial response can identify the missing decisions before the project-specific quotation is fixed.

What is the practical warehouse demolition planning workflow?

The seven project-governance decisions below make responsibilities visible to the buyer. The consultant-approved method statement controls the physical dismantling order.

  1. Define handover: agree the physical boundary and final condition before pricing.
  2. Identify permissions: establish the competent building authority, owner permissions, utility route and released workfront requirements.
  3. Survey: review structure, connections, bracing, services, ground, access and neighbouring operations.
  4. Choose method families: compare recovery dismantling, controlled cutting and suitable mechanical demolition for each component.
  5. Obtain engineering acceptance: have the relevant designers and consultant address retained stability, temporary works, lifting and access interfaces.
  6. Allocate commercial responsibility: agree laydown, haulage, scrap, waste, measurement, scope exclusions and evidence ownership.
  7. Approve and close out: issue the authorised work packs, record removals against released fronts and provide the agreed handover evidence.

Stone Beam’s demolition planning typically includes a site visit and structural assessment, services review, method statement and risk assessment, engineered phasing, monitoring where required, controlled debris removal and handover. We work within a documented HSE and environmental management framework covering readiness, supervision, emergency planning and environmental controls.

Warehouse component decision matrix

Use this matrix to check that each component has an agreed decision and its own commercial boundary. It is particularly useful when a tender mentions “full demolition” but attaches a different list of exclusions.

Component Decision to close Evidence / input Method family Commercial boundary
Roof / cladding Recover intact, section, or remove as waste? Material, fixings, condition, access Manual/mechanical removal or controlled sectional removal Recovery quality, stacking, disposal
Primary steel frame Recover, cut into pieces, or demolish as non-recoverable structure? Frame/bracing, connections, condition, piece handling Controlled dismantling, cutting, or mechanical demolition Steel ownership, lifting/handling, secondary processing
Mezzanine / gantry Retain, remove independently, or remove with frame? Load path, supports, retained interfaces, services Separate engineered removal strategy Boundary with tenant/process/retained structure
Slab / hardstanding Retain, local removal, or full removal? Thickness/records, buried services, future use Breaking, cutting or retained protection Debris loading, formation level, damage limits
Foundations / pits Retain, partial removal, or full removal? Foundation records, adjacent assets, excavation limits Engineered concrete removal under a separately specified below-ground scope Backfill, compaction, survey, below-ground risk
Utilities / MEP De-energise, recover, divert, or retain live? Owner/utility release, drawings, field verification Specialist isolation/soft strip before structural work Utility responsibility and release evidence
Steel / waste stream Reuse, scrap, recycle, or dispose? Ownership, measurement, destination, records Segregation and controlled handling Credit, transport, disposal and documentation

Who is responsible for each demolition interface?

The owner, engineer, demolition contractor and specialists need a written allocation. The table below is an RFQ responsibility prompt, not a statement that one arrangement applies by law to every plot.

Interface Typical accountable decision-maker Evidence to request in the tender
Removal limits and retained contents Owner or tenant with contractual authority Approved scope mark-up and asset inventory
Structural assessment and retained stability Appointed competent structural/temporary-works engineer Assessment, design responsibility and acceptance path
Main demolition permit and NOCs Applicant designated under competent authority rules; owner supplies required consents Permit responsibility matrix and submission tracker
Electricity, water, telecom and process releases Utility / asset owner / authorised specialist Release confirmations and outstanding actions
Demolition method, HSE and workfront supervision Demolition contractor, under consultant/authority approval requirements Method statement, risk assessment and supervision plan
Crane/lifting design and related checks Competent lifting-design and appointed lifting parties Approved lifting-plan responsibility and equipment interface
Waste carriage and destination Appropriately authorised carrier and receiving facility Carrier/facility route and required waste tickets
Scrap title and credit Party named in the contract Retention/transfer terms and measurement method
Final handover Owner/consultant and the defined trade package Inspection schedule, records, survey and acceptance certificate as applicable

How should a warehouse demolition contractor be assessed?

Ask for a trade licence with relevant activity, applicable practice-permit or qualification category, project-specific permit responsibilities, a method statement and risk assessment suited to the actual warehouse, engineering and lifting-design allocation, HSE documents, suitable insurance evidence, licensed waste-carrier arrangements, and real evidence for any specific completed-project claim. A licence is not a demolition permit for your plot, and a purchase order is not a completion certificate.

Stone Beam Demolition is the trading name of Stone Beam Technical Services L.L.C., trade licence 1563419, with Wrecking & Demolition Works among its registered activities and a Dubai Municipality demolition practice-permit category of G+12. The practice permit records contractor qualification, not approval for this warehouse. The company’s founder, Eng. Awad Ashour, brings more than 15 years of demolition experience in the UAE. Our company and credentials information provides a route for commercial verification. You can also use the demolition contractor prequalification checklist to compare documentation between bidders.

When is warehouse demolition also facility decommissioning?

An empty warehouse shell and a warehouse attached to a working process facility are different assignments. If the site includes live process equipment, bulk storage, tanks, chemical systems, refrigeration or production services, the operator must define shutdown, inventory removal, specialist isolation and release evidence separately from structural demolition. The demolition scope then begins at the agreed boundary between cleared assets and the structures being removed.

We dismantle released plant and facility structures as part of the demolition-side package once the operator’s specialists have cleared them. The consultant and owner should identify which specialist certifications must be received before the structural workfront is released.

Frequently asked questions

Is recovered steel automatically the demolition contractor’s property?

No. Steel, equipment and other recovered material remain subject to the contract and the owner’s asset rights. State who owns each stream, whether a scrap credit is included, and how quantities are measured.

Are the slab and foundations automatically included in warehouse demolition?

No. A steel-shell removal, full slab demolition and underground-foundation removal are distinct scopes. Show each on the drawings and give each a separate acceptance condition.

Does every Dubai free-zone warehouse follow the same permit route?

No. First identify the building authority for the plot. DDA and Trakhees have different service routes, and the relevant developer, utilities and other authorities may require additional documents.

Is steel warehouse dismantling the same as industrial decommissioning?

No. Steel dismantling concerns structural components; decommissioning also addresses process shutdown, isolation, cleaning and asset-owner release. A project can need both, but the documents and responsible specialists must be distinguished.

What information is needed to estimate demolition cost?

A measured scope, structural type and condition, access plan, slab and foundation limits, occupied boundaries, utility and hazard status, waste responsibilities, scrap ownership and the required handover state. They matter more than floor area alone.

Can a contractor promise a standard number of days for any warehouse?

A programme should follow the actual surveys, permissions, service releases, method approval, structural scope and loading constraints. Authority service estimates describe particular approval steps, not guaranteed construction durations.

What happens if adjoining warehouses stay occupied?

The retained bay, services, weatherproofing, boundaries, escape routes and tenant access need review before the method is agreed. The engineer defines retained-stability requirements, while the owner and contractor agree on operating interfaces.

What if asbestos-containing materials are suspected in the roof?

Record the suspected materials and arrange assessment and any removal or clearance through an appropriately authorised hazardous-material specialist. The demolition scope and programme are then coordinated around that specialist’s documented release.

Can a fire-damaged warehouse be dismantled for steel reuse?

The condition of the frame and connections must first be assessed by the competent engineer, alongside any authority or investigation held. Reuse decisions need evidence of suitability, not appearance alone.

What is the most useful handover document for the owner?

A defined acceptance record linked to the scope: what was removed, which retained assets were inspected, required waste and clearance evidence, final levels or survey where specified, and any outstanding exclusions.

Request a warehouse demolition scope review

Send your warehouse drawings for a scope and quotation review. Our demolition planning covers the structural removal boundary, appropriate dismantling or demolition method families, slab and foundation options, retained-asset interfaces and debris handling, with the consultant’s engineering releases defining the project-specific method.

Include the plot or authority details, roof/frame drawings, a few recent site photographs, occupancy and utility status, a remove/retain plan, scrap-title decision, foundation scope, target handover condition and your consultant’s contact. Contact Stone Beam Demolition to begin the review.

Tags:
Leave a Reply

Your email address will not be published.Required fields are marked *

Published on

September 14, 2026

Share on
